THIS ANNOUNCEMENT CONTAINS INSIDE INFORMATION AS STIPULATED UNDER THE UK VERSION OF THE MARKET ABUSE REGULATION NO 596/2014 WHICH IS PART OF ENGLISH LAW BY VIRTUE OF THE EUROPEAN (WITHDRAWAL) ACT 2018, AS AMENDED. ON PUBLICATION OF THIS ANNOUNCEMENT VIA A REGULATORY INFORMATION SERVICE, THIS INFORMATION IS CONSIDERED TO BE IN THE PUBLIC DOMAIN.
8 September 2026
Total Graphite plc
('Total Graphite' or the 'Company')
Encouraging Vatomina Infill Drilling Results
Total Graphite plc (TGR.L), the specialist flake graphite company and supplier of the critical mineral for the global energy transition, is pleased to provide an update on its ongoing exploration and resource-definition drilling programme at its Vatomina Project in Madagascar, including encouraging initial infill drilling results from the Old Mine area.
Highlights
• Positive initial infill results at Old Mine: diamond hole VAT-DD26-026 returned 19m at 3.3% TGC from 36m downhole, including 5m at 6.82% TGC from 44m.
• Continuity confirmed: in context with historical drilling and mining data, the results are very encouraging in terms of confirming the continuity of a thick near surface graphite seam and support a much clearer understanding of the orebody ahead of the restart mine plan.
• New Old Mine Extension defined: auger drilling and trenching have exposed a section to the east of the historical workings, the Old Mine Extension, over which a completed cross-section indicates that a significant graphitic resource is potentially present.
• Next steps: drilling is ongoing ahead of block modelling and pit-shell optimisation to determine the extent and economics of mining this section of the orebody, together with the previously announced Tanandava orebody, to support a robust restart mine plan.
Background to the Drilling Programme
In July 2026, the Company commence a drilling programme at Vatomina to increase the confidence level of the current resources and expand the resource base, with the objective of supporting an updated mine plan and optimising future mining operations.
Previous mining at Vatomina was undertaken in the areas known as Pit B and Old Mine (see Figure 2, Plan Map and Figure 3, Longitudinal Section below). Auger drilling and trenching have since been conducted and have exposed a section to the east (the "Old Mine Extension"). A programme of in-pit logging and mapping has assisted in determining the direction of folds and faults along the dolerite dykes that cut the sequence, improving the structural understanding of the deposit.
Old Mine Infill Drilling Results
The results from hole VAT-DD26-026 returned a substantial and well-mineralised graphite intercept. A summary of the principal intercept, reported as downhole (apparent) widths, is set out below:
|
Hole ID |
From (m) |
To (m) |
Downhole width (m) |
TGC (%) |
|
VAT-DD26-026 |
36 |
55 |
19 |
3.3 |
|
including |
44 |
49 |
5 |
6.82 |
Notes: TGC = total graphitic carbon. Intervals are reported as downhole (apparent) widths; true widths are expected to be lower and will be determined following completion of geological modelling. Grades are length-weighted averages of one- to two-metre sample intervals. Reported intervals apply a nominal lower cut-off and may include internal dilution.
The intercept demonstrates a coherent, well-developed graphite seam at Old Mine and is consistent with the historical drilling completed across the area between 2018 and 2026. The infill result increases confidence in the continuity and tenor of the seam in this part of the deposit and provides important input for the forthcoming resource model and restart mine plan.

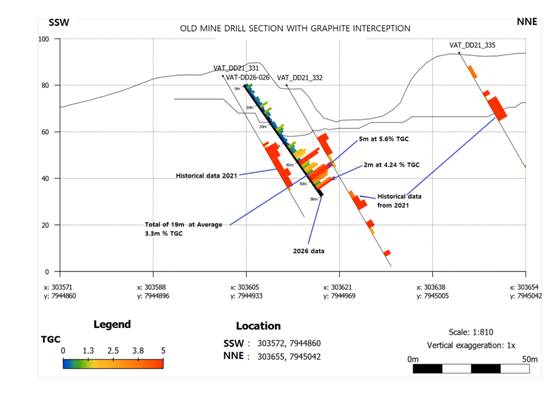

Figure 1: Old Mine drill section showing the graphite interception in hole VAT-DD26-026 (19m at 3.3% TGC, including 5m at 5.6% TGC and 2m at 4.24% TGC), in context with historical 2021 drilling. Colours denote TGC%.
The completed cross-section confirms that significant mineralisation is present in this area. The section, together with the plan and longitudinal section below, illustrates the position of the 2026 drilling relative to the previously mined Pit B and Old Mine areas and the interpreted continuity of the graphite band.

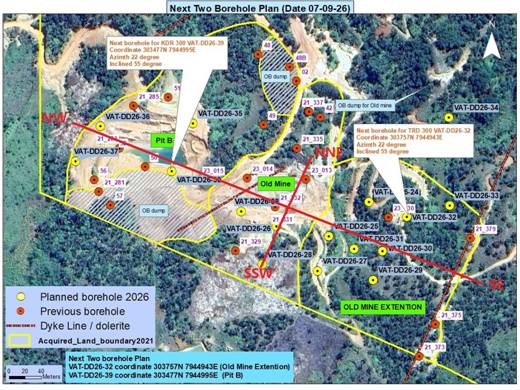

Figure 2: Plan map of the Pit B to Old Mine Extension area, showing planned 2026 boreholes, previous boreholes, the interpreted dyke / dolerite line and the acquired land boundary.

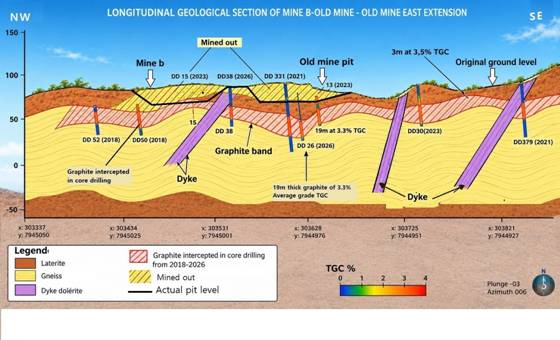

Figure 3: Longitudinal geological section from Mine B through Old Mine to the Old Mine East Extension, showing the graphite band intercepted in core drilling from 2018 to 2026, the mined-out areas and cross-cutting dolerite dykes.
Next Steps
Drilling is ongoing. The results will be modelled into an updated geological and resource model, following which block modelling and pit-shell optimisation will be undertaken to determine the extent and economics of mining this section of the orebody, together with the previously announced Tanandava orebody. This work is intended to support a robust mine plan for the restart of mining operations at Vatomina.
The Company looks forward to updating shareholders as further results are received and as the geological modelling and mine planning work progresses.
Christian Dennis, Chairman of Total Graphite plc, commented:
"These first infill results from the Old Mine area are exactly what we had hoped to see. A 19-metre graphite intercept, with a notably high-grade core, gives us real confidence in the continuity and quality of the seam and, taken together with our historical data, brings the shape of the orebody into much sharper focus.
With drilling ongoing and the newly defined Old Mine Extension adding to the opportunity, we are in the process of building a robust geological understanding to underpin a credible restart mine plan. As we move into block modelling and pit optimisation across both Old Mine and Tanandava, we look forward to demonstrating the scale and value of the resources we have to mine at Vatomina."
ENDS
Enquiries:
|
Total Graphite plc Christian Dennis - Chairman Arun Somani - Chief Executive Officer Thomas Hill - Finance Director |
info@totalgraphite.com IR@totalgraphite.com |
|
AlbR Capital Limited - Financial Adviser David Coffman / Dan Harris |
+44 (0) 20 7469 0930 |
